Skip to content
LNGVaulta CNGdelivery company

Regulatory and safety

LNG storage is regulated. We run the process while the equipment is being built.

NFPA 59A siting, recertified vessels, and an AHJ package prepared in parallel with refurbishment.

The codes

  • NFPA 59A, the standard for LNG production, storage, and handling, adopted through state and local fire codes.
  • 49 CFR Part 193 and PHMSA for facilities under federal jurisdiction.
  • ASME Section VIII and the National Board R-stamp for any repair to pressure-retaining parts.
  • Local fire code, zoning, and environmental review as applied by the authority having jurisdiction.

Siting

  • Thermal-exclusion setbacks of about 25–50 ft from tanks to property lines and structures.
  • Heated vaporizers at least 100 ft from a buildable property line and 50 ft from the LNG container.
  • Secondary containment: double-wall vessels or impoundment sized to the largest tank.
  • Vapor-dispersion and thermal-radiation analysis per NFPA 59A for the specific site.

Equipment integrity

  • Every vessel inspected and recertified before deployment; vacuum readings documented.
  • R-stamp on any pressure-vessel repair.
  • Relief valves inspected and set-point tested every 2 years (maximum 30 months).
  • GuardLogix safety PLC, ESD, gas and flame detection, interlocks in the control container.

The AHJ process

1

Pre-application

Site arrangement, setbacks, and containment concept presented to the AHJ before filing.

2

Submittal

NFPA 59A compliance package, P&IDs, electrical and controls drawings, emergency plan outline.

3

Review and approval

Comment responses, inspections at installation and commissioning. Typically 6–18 months in total.

Permitting runs in parallel with the 60–120 day refurbishment and shipping window. The equipment is never the critical path; the AHJ is, and we work it from day one.

Why gas permits where diesel cannot

LNG with CryoSurgeDiesel generators
Non-emergency run limitPer air permit; can run as primary supplyEPA: 50 hours a year; CA SB 887/978, WA (25 hr at Sabey), NY moratorium
Fuel shelf lifeDoes not degrade; active boil-off management in standby6–12 months; fuel polishing required
Emissions40–70% lower; easier NOx and PM2.5 permittingNOx and PM2.5 limits increasingly binding
Bridge power for yearsYes, then backupNot legally

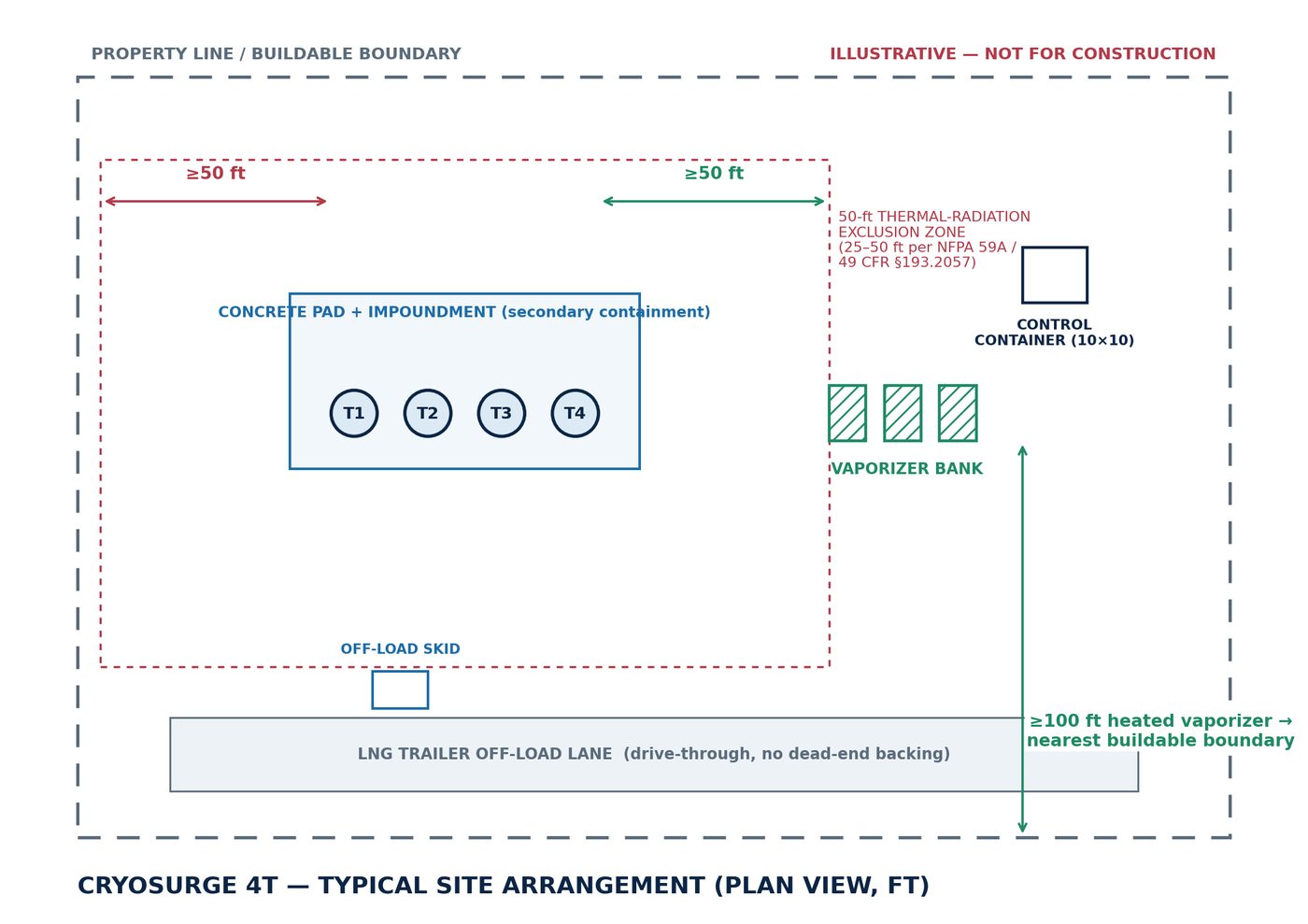

Illustrative site arrangements for CryoSurge 3T and 4T are available on the module pages and as a downloadable template on the resources page. Not for construction.

Next steps

From first call to equipment on site in 60–120 days.

  1. Site screening call within a week: load profile, timeline, pipeline and grid status. We size the configuration.
  2. Budgetary proposal in 10 business days: purchase and lease pricing, deployment schedule, site arrangement.
  3. Inspection and data room: visit the Texas yard or review drawings, inspection reports, and recertification records.
  4. Contract and deployment: equipment ships in 60–120 days; NFPA 59A permitting runs in parallel.

Request a quote

LNGVault, a CNGdelivery company1 (800) 716-6747 · dmitri@gasequipmentforsale.com

Equipment offered subject to availability. Capacities and runtimes are engineering estimates at 40% net electric efficiency and LNG at 82,644 Btu/gal (LHV); final figures are confirmed per project. Lease and EPC pricing indicative. Siting subject to NFPA 59A and local AHJ approval. Renderings are conceptual. LNGVault stores and delivers fuel; power generation is provided by the customer or a named generation partner.
